Nearshoring vs Offshoring: How to Choose Your Manufacturing Footprint and EMS Partner

Written by Zsolt Borsi

October 17, 2026

nearshoring vs offshoring
Nearshoring vs offshoring is usually framed as a fight. One side says build close to your customers. The other says build where costs are lowest. Pick a winner and move on.
That framing is out of date. The hardware brands handling today’s tariffs, shortages and demand swings best aren’t choosing one model. They’re running both, deliberately, and matching each product to the footprint that suits it.

This guide explains the difference between nearshoring and offshoring, when each one wins, and how to choose an electronics manufacturing partner that can support the right mix.

Nearshoring vs Offshoring Comparison
“Supply chain leaders are moving away from an overreliance on low-cost networks and are instead focusing on diversified approaches to mitigate risks and enhance performance.”- Vicky Forman, Senior Director Analyst, Gartner (14 Aug 2024)

Nearshoring vs offshoring: the definitions

  • Offshoring means manufacturing in a distant country, usually to access lower costs, scale or a specialised supply base. For North American and European brands, this has traditionally meant Asia.
  • Nearshoring means manufacturing in a nearby country, close to the end market. For North America, that is usually Mexico. For Western Europe, it is often Central and Eastern Europe.
  • Reshoring (or onshoring) means bringing manufacturing back into the home country.

The difference is not just distance. It is about which trade-off you are optimising for: cost and scale, or speed and proximity.

Nearshoring vs offshoring compared

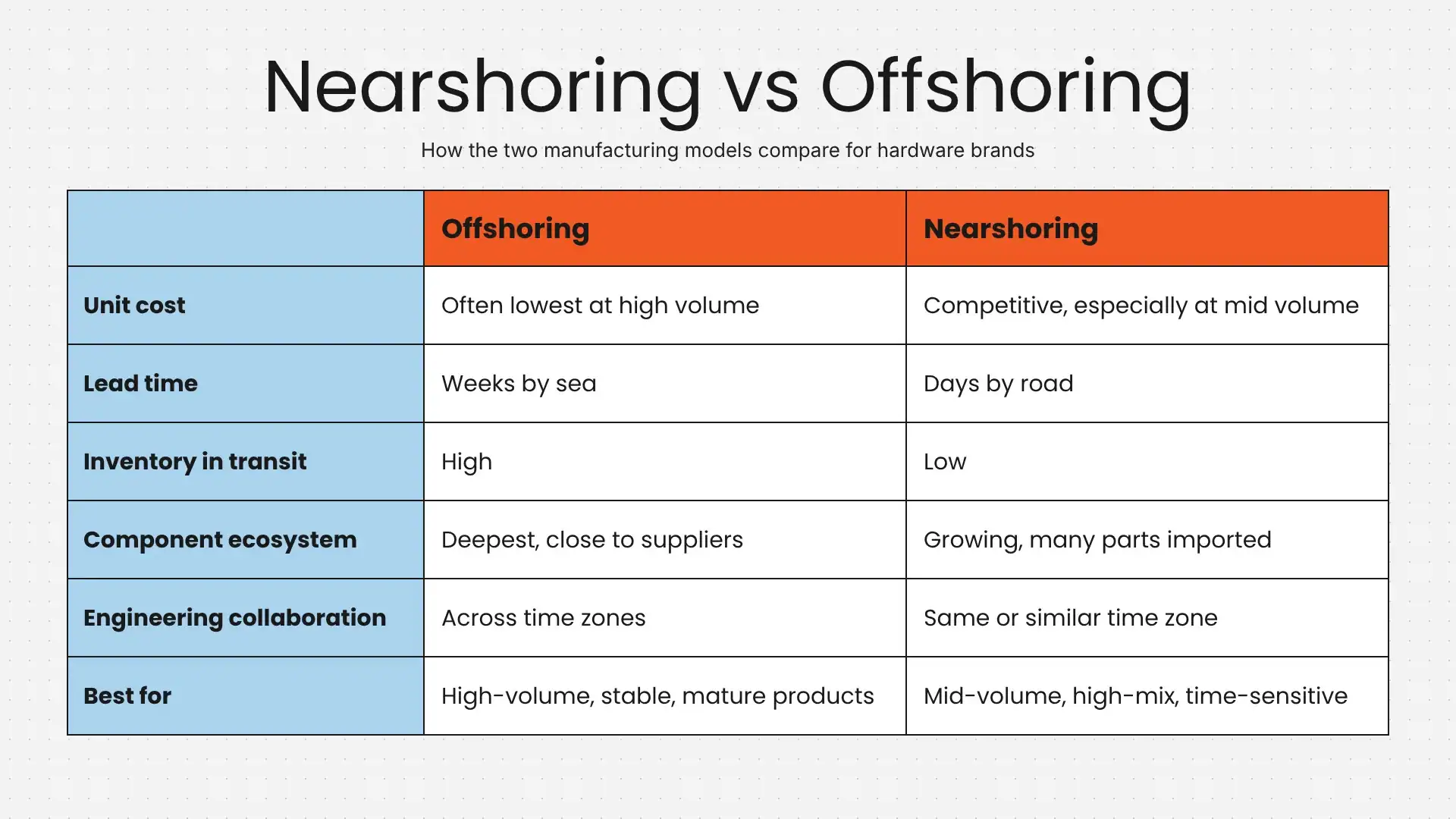

Factor Offshoring Nearshoring
Unit cost Often lowest at high volume Competitive, especially at mid volume
Lead time to market Weeks by sea Days by road
Inventory in transit High Low
Component ecosystem Deepest, especially in Asia Growing, but many parts still imported
Engineering collaboration Harder across time zones Easier, similar time zones
Tariff and trade exposure Depends on trade relations Often reduced by regional trade agreements
Flexibility for design changes Slower Faster
Best for High-volume, stable, mature products Mid-volume, high-mix, time-sensitive or regulated products

Transit Time Days Not Weeks
Global container schedule reliability fell to 49.9% in August 2026, and late vessels arrived an average of 6.81 days behind schedule.

When offshoring still wins

It is fashionable to say offshoring is over. It isn’t. Offshoring still makes sense when:

  • Volumes are very high and stable. Scale economies in established manufacturing hubs are hard to beat for mature products.
  • The component supply chain is local to the factory. Building next to your suppliers cuts component lead times and logistics cost.
  • The product sells globally. If only a fraction of volume goes to one region, building it there may not pay off.
  • Specialist processes are needed. Some advanced processes and capacity are concentrated in particular regions.

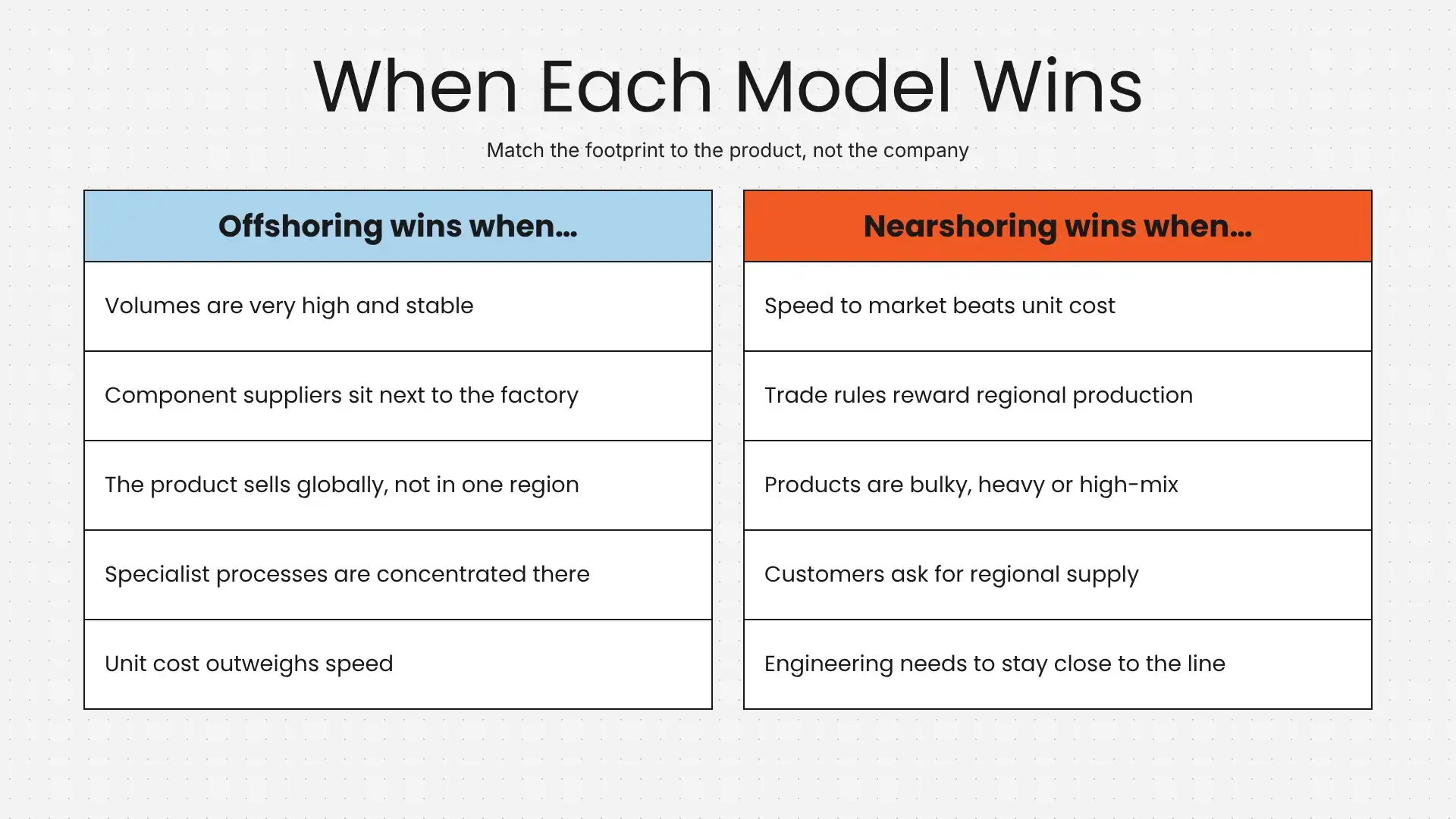

When Each Model Wins
“Organizations that treat network decisions as adaptable, rather than fixed, are better equipped to protect margins and respond to change.” – Vicky Forman, Gartner (14 Jul 2026)

When nearshoring wins

Nearshoring tends to win when:

  • Speed matters more than unit cost. Seasonal products, fast product cycles and custom configurations all benefit from short lead times.
  • Trade rules reward regional production. In North America, products that qualify under USMCA currently avoid the Section 301 duties introduced in July 2026. Our guide to USMCA rules of origin for electronics explains how qualification works.
  • Products are bulky, heavy or high-mix. Freight cost and complexity rise quickly with size and variety.
  • Customers demand regional supply. Automotive, medical and industrial buyers increasingly ask for local or regional capacity as part of their own risk planning.
  • Engineering needs to stay close. New product introduction, frequent engineering changes and quality investigations all move faster when the factory is nearby.

The scale of the North American opportunity is clear. According to the Congressional Research Service, Mexico was the largest supplier of goods to the US in 2025, with $534.8 billion in US imports.

US Mexico Trade 2025
Mexico received US$40.9 billion (USD 40,871 million) in foreign direct investment in 2025, 10.8% more than the figure first reported for 2024.

The case for “both”: multi-region manufacturing

Here is the model we see working best:

Design centrally. Source globally. Build close to demand.

In practice, that means:

  1. One engineering core that owns the design, test strategy and manufacturing documentation, so any site can build the product the same way.
  2. Global component purchasing at scale, because most electronic components are made in a limited number of places regardless of where final assembly happens.
  3. Regional final assembly in each major market, sized to that market’s demand.
  4. The ability to shift volume between regions when tariffs, demand or capacity change.

This is not a theoretical model. It is how a growing number of hardware brands now protect themselves against the next disruption, without giving up the cost advantages of established manufacturing hubs. It also builds on the shift from reactive to proactive planning we covered in supply chain management: from reactive to proactive.

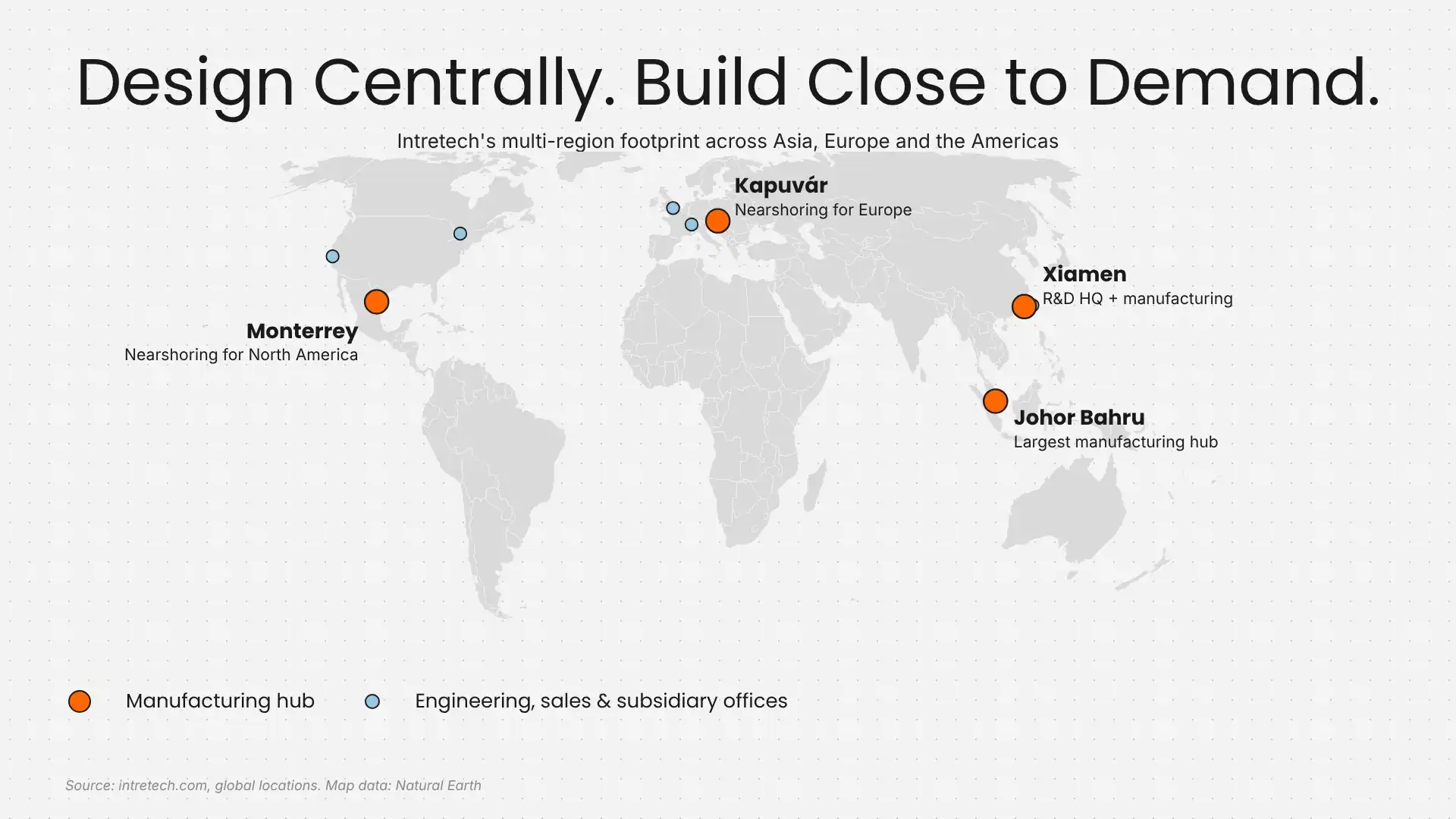

Intretech Global Footprint Map
“Supply chain footprints are evolving, with 73 percent of survey respondents reporting progress on dual-sourcing strategies.”

Total landed cost: the only fair comparison

Comparing a unit price from one region with a unit price from another is the most common mistake in footprint decisions. Compare total landed cost instead:

  • Unit cost (materials, labour, overhead)
  • Freight, insurance and brokerage
  • Duties and tariffs on finished goods and components
  • Inventory carrying cost across the transit time
  • Quality cost during ramp-up
  • Engineering travel and support
  • The expected cost of disruption

Run the numbers at several volume levels and tariff scenarios. The answer often changes with volume, and that is a strong signal that a mix of footprints is right.

A quick decision checklist

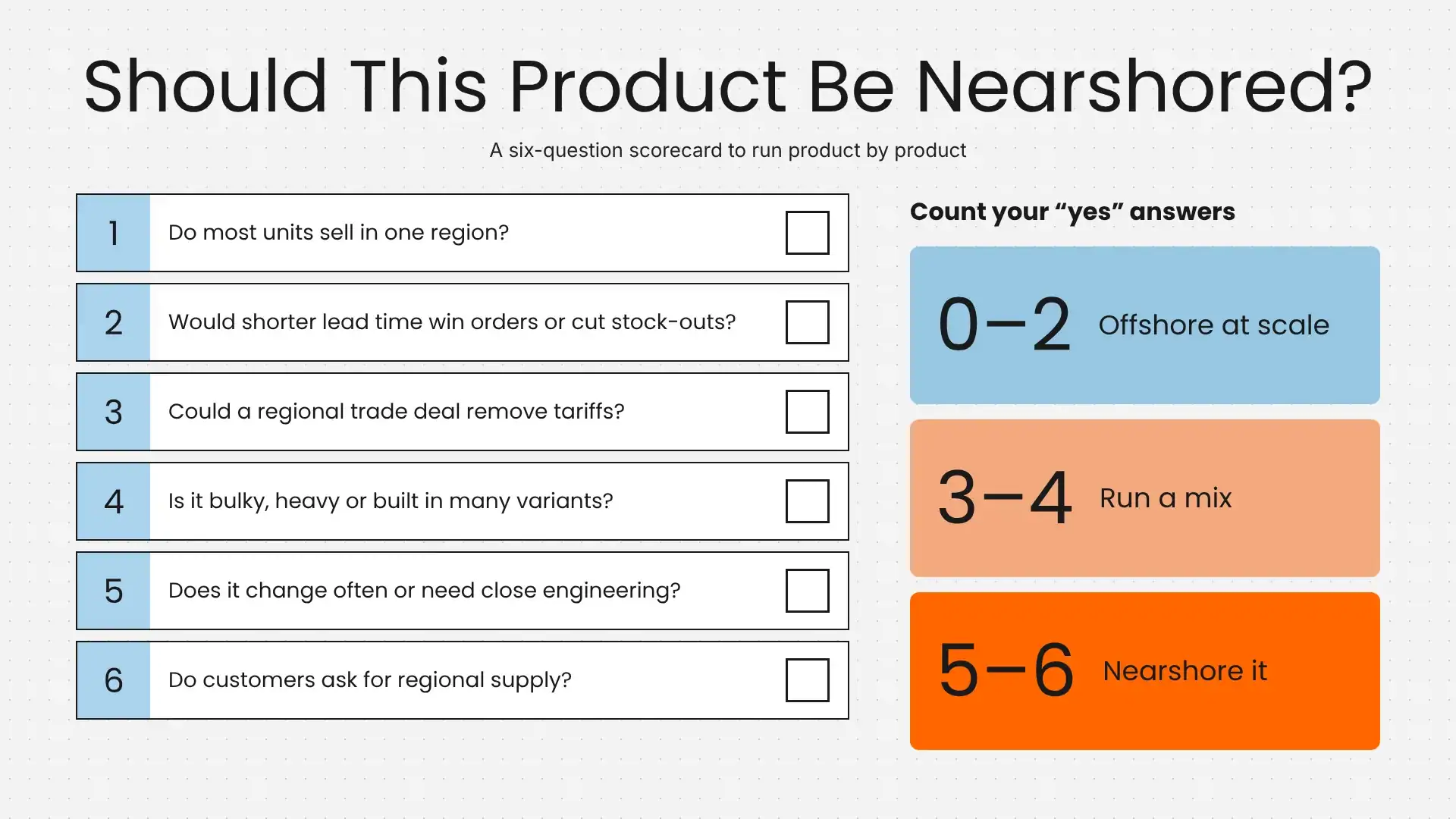

Score each product against these questions. The more “yes” answers, the stronger the case for nearshoring it.

  • Do most units sell in one region?
  • Would a shorter lead time win orders or reduce stock-outs?
  • Does the product face tariffs that a regional trade agreement could remove?
  • Is it bulky, heavy or produced in many variants?
  • Does it change often, or need close engineering support?
  • Do your customers ask for regional supply?

If a product scores low on all six, offshoring at scale is likely still the better fit. Most portfolios end up with a mix, which is exactly why the footprint decision should be made product by product, not company-wide.

Nearshoring Scorecard
“60 percent of respondents are acting to regionalize their supply chains.” Source: McKinsey Global Supply Chain Leader Survey 2024 (14 Oct 2024)

How to choose a contract electronics manufacturer for nearshoring or offshoring

Whichever model you choose, your partner’s capability decides how well it works. Ask these seven questions.

1. Where can they build, today?

Ask for a site-by-site view of live processes: SMT, PCBA, injection moulding, final assembly and testing. Planned capability is not capability.

2. Are certifications site-specific?

ISO 9001 is the baseline. IATF 16949 matters for automotive and ISO 13485 for medical devices. Make sure each certificate covers the site that will build your product.

3. How strong is their component sourcing?

Global purchasing power and supplier relationships protect you during shortages. Ask how they manage allocation and long lead-time parts.

4. Can they move a product between sites?

A documented production transfer process should include golden samples, first article inspection, parallel builds and formal sign-off. This is what makes a multi-region footprint real.

5. Do they offer design and engineering support?

A contract design and electronics manufacturer (CDEM) can help with DFM, test development and design changes that improve cost or trade compliance. An EMS provider that only builds to print may not.

6. Do they understand trade rules?

A good partner can explain how sourcing and process choices affect USMCA origin in North America, or customs status in Europe.

7. Are they financially and operationally stable?

Look at scale, years in operation, customer references and investment in new capacity.
Our guide to OEM procurement strategy for OEM vs ODM sourcing covers how to structure the commercial relationship once you have chosen.

Intretech by the Numbers
North American EMS bookings rose 53.5% year on year in August 2026, with a book-to-bill ratio of 1.39. Source: Global Electronics Association

How Intretech supports both models

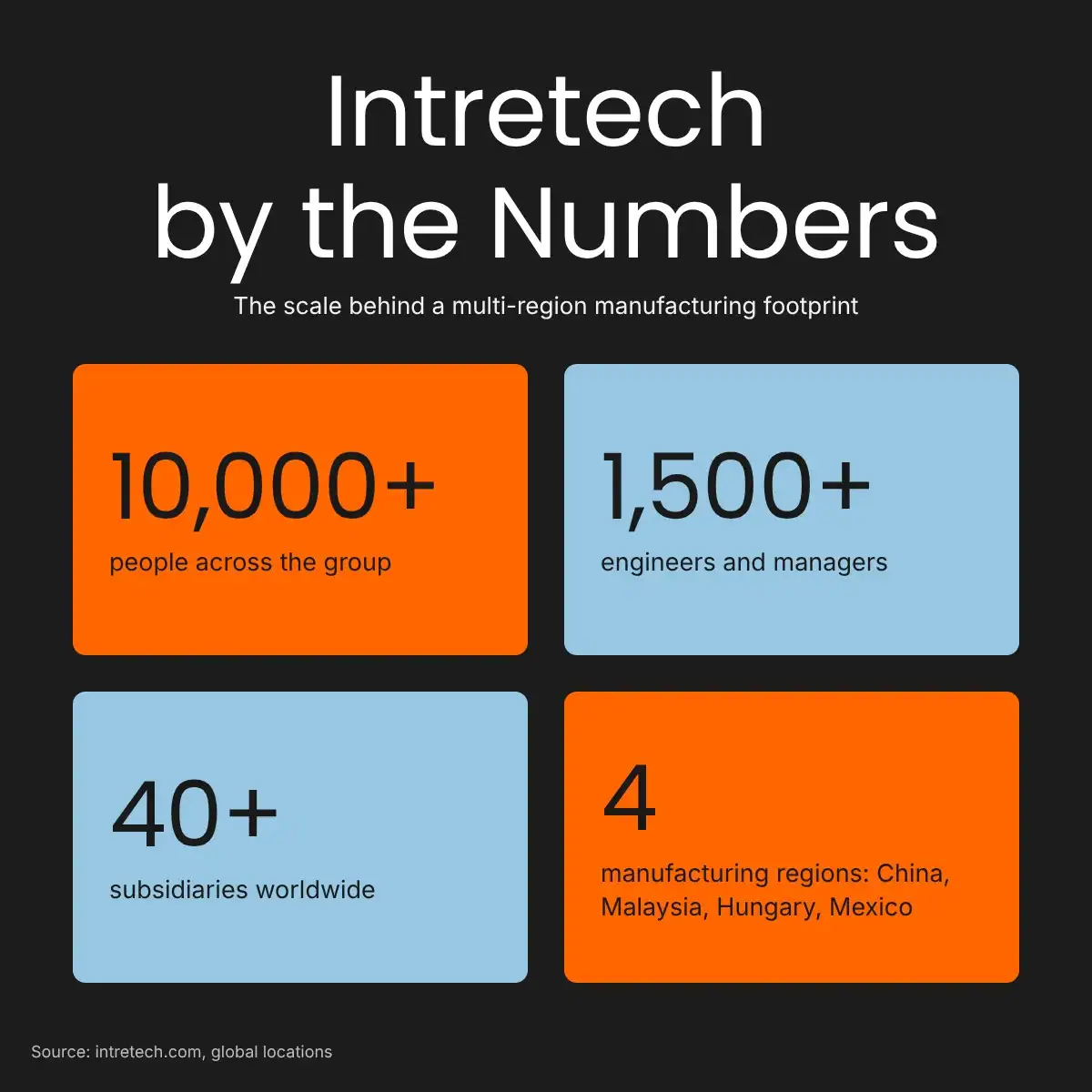

Intretech is a global contract design and electronics manufacturer with more than 10,000 people and over 1,500 engineers and managers. Our manufacturing footprint is built for multi-region production:

  • Asia: large-scale manufacturing and R&D in China, and our largest manufacturing hub in Johor Bahru, Malaysia, with over 210,000 m² of manufacturing space.
  • Europe: a nearshoring base in Kapuvár, Hungary, serving European markets. See our Hungary facility.
  • Americas: our facility in the Monterrey area of Mexico, opened in 2024 to serve North American customers.

That lets customers design once, source at global scale and build in the region that makes sense for each product. Read our full buyer’s guide to electronics manufacturing in Mexico or explore our global locations.
